Understanding the PK4 Automated Scheduling Engine

Table of Contents
ToggleManaging project schedules in Salesforce can get messy fast -especially when every task change triggers a ripple effect across your timeline. That’s where the PK4 Automated Scheduling Engine steps in. Built into PK4 Project Management, this intelligent automation works quietly in the background every time you create or update a task. It instantly recalculates dependencies, aligns deadlines, and keeps your project plan consistent, accurate, and up to date. By handling the complex math of scheduling for you, PK4 reduces manual effort, minimizes errors, and helps you focus on what really matters—delivering projects on time.
The automation is built on three core concepts that work together to define your project’s timeline. Understanding how they interact is key to mastering your project plan.
The Three Pillars of Your Project Schedule
- Task Hierarchy (WBS): This is the “family tree” of your tasks, defining parent-child relationships (e.g., Task 1.2 is a child of Task 1). Parent tasks act as summary containers for the work of their children.
- Task Dependencies: These are the logical links between tasks that define the sequence of work. For example, one task must finish before another can begin.
- Date Constraints: These are the fixed rules or deadlines you set on a task, such as a mandatory start date or a contractual delivery deadline. They act as anchors in your schedule.
The system processes changes in a specific order: it first synchronizes the Task Hierarchy, then calculates the impact on Dependencies, and finally checks for any violations of Date Constraints.
Pillar 1: Task Hierarchy (Parent-Child Synchronization)
The system ensures that a parent task and all its descendants (children, grandchildren, etc.) are always logically connected. This works in two directions: from the top-down and from the bottom-up.

Top-Down Cascade: Moving a Parent Task
When you manually change the dates of a parent task, the system treats that entire branch of your project as a single, rigid block.
- How it Works: If you move a parent task’s start date forward by five days, the system automatically moves the start and end dates of all its children, grandchildren, and other descendants forward by those same five days. This action preserves the internal timing and logic of that entire section of your plan.
- Industry Examples:
- Construction: You reschedule the “Phase 2: Interior Finishing” summary task to start a week later. The system automatically pushes all its children—like “Install Drywall,” “Run Electrical,” and “Lay Flooring”—back by one week.
- Software Development: The “Sprint 4” summary task is pulled forward by two days to meet a new deadline. All the user stories and sub-tasks within that sprint are automatically moved two days earlier.
- Event Planning: The parent task “Venue Setup” is delayed by a day. All its children, such as “Set up Lighting,” “Arrange Seating,” and “Sound Check,” are automatically postponed by one day.
Bottom-Up Roll-Up: How a Child’s Change Affects the Parent
A parent task is a summary container; its date range must always be large enough to hold the schedules of all its children. When a child task’s dates change, the parent’s dates will automatically adjust to remain an accurate summary. This “roll-up” continues all the way to the top-level project task.
- How it Works (Expansion): A team member delays their task, “Develop Login Page,” causing its end date to move from August 25th to August 30th. Its parent, “Build User Authentication Module,” had an end date of August 28th. The system automatically extends the parent’s end date to August 30th to contain the delayed child task.
- How it Works (Contraction): A parent task has only one child. If that child task finishes three days earlier than planned, the parent’s end date and duration will automatically shrink by three days to mirror its child’s schedule accurately.
Industry Examples:
– Manufacturing: The “Source Raw Materials” task is completed ahead of schedule. Its parent, “Phase 1: Procurement,” automatically contracts, showing the updated, shorter timeline for that phase.
– Marketing: A third-party vendor is late delivering ad visuals, so the “Design Ad Creatives” task is delayed. This automatically pushes out the end date of its parent task, “Execute Digital Ad Campaign,” giving the project manager immediate visibility of the impact.
Pillar 2: Task Dependencies
Dependencies create a logical flow of work, and the system ensures this flow is maintained. The automation is a one-way street, flowing from the first task (predecessor) to the second task (dependent).

- How it Works: The system is set to automatically calculate dependent dates. If “Pour Foundation” (predecessor) is linked to “Erect Frame” (dependent) with a “Finish-to-Start” dependency, delaying the foundation by two days will automatically push the start of the frame erection back by two days.
- The Relay Race Analogy: Think of a relay race. When the first runner finishes determines when the second can start. However, if the second runner decides to wait longer, it doesn’t change when the first runner finished. Moving a dependent task will never change the dates of its predecessor.
Industry Example:
– Publishing: The task “Finalize Manuscript” is a predecessor to “Design Book Cover.” If the manuscript finalization is delayed by a week, the “Design Book Cover” task will be automatically pushed back by a week. If the designer manually moves their task to start even later, it won’t affect the manuscript’s schedule, but it may create a conflict if it violates other rules.
Pillar 3: Date Constraints
Date Constraints are the hard-and-fast rules you set. They are the most powerful of the three pillars and act as anchors in your plan that other automated changes must respect.

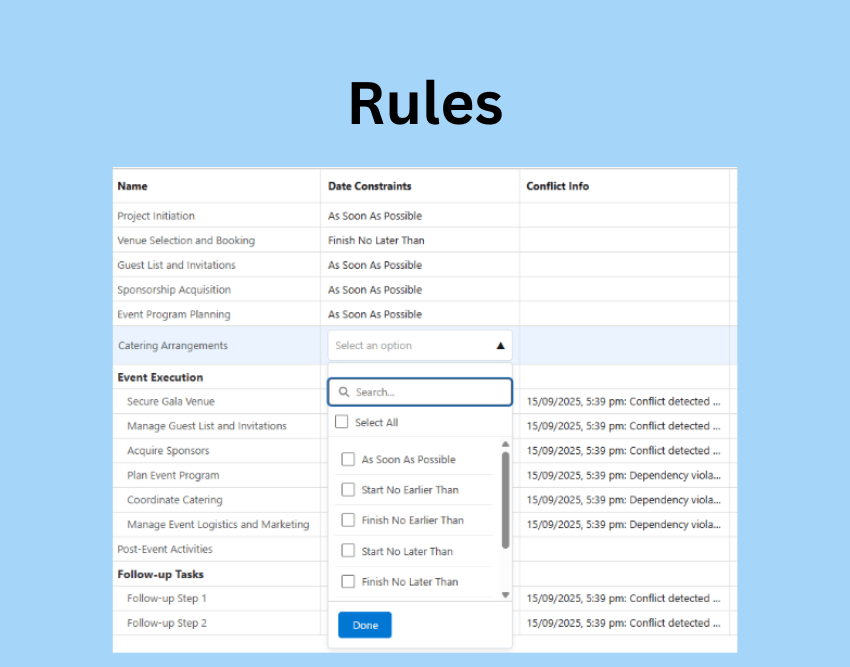

PK4 Project Management supports the following constraints:

- Must Start On: The task must begin on this specific date. It will not be moved earlier or later by dependencies.
Example: A “Project Kickoff Meeting” task for a client is set for a non-negotiable date.
- Must Finish On: The task must end on this specific date.
Example: A “Submit Final Report” task that is tied to a contractual deadline.
- Start No Earlier Than: The task can start on or after this date, but not before.
Example: A “Begin Construction” task that cannot start until the building permit is issued on a known date.
- Start No Later Than: The task must begin on or before this date.
Example: A seasonal “Planting” task on a farm that must begin before the first frost.
- Finish No Earlier Than: The task can end on or after this date.
Example: A “Hold Shipment” task where goods cannot be released from a warehouse before a specific date.
- Finish No Later Than: The task must end on or before this date.
Example: A “Complete User Testing” task that must be finished before a major software release conference.
How Conflicts Are Managed: Your Changes Come First
A conflict occurs when a user’s action or an automated adjustment violates one of the rules. The system is designed to give your manual changes priority and make the resulting problem visible, rather than blocking your action or making silent, unwanted changes.
- The Philosophy: When a rule is broken, the system flags the task with a conflict but allows your change to proceed. This ensures you remain in full control of the project plan while being immediately notified of any scheduling issues that arise.
- What You See: When a conflict occurs, the Conflict Reason field on the task is automatically populated with a clear message explaining the problem (e.g., “Dependency violated: This task now starts before its predecessor ‘Pour Foundation’ has finished.”).
Example Scenario: How the Pillars Interact
Let’s see how the rules work together in a real-world scenario.
- The Setup:
- You have a task, “Submit Permit Application,” which ends on August 29th.
- It is a predecessor to “Begin Site Excavation,” which is scheduled to start on September 1st.
- The “Begin Site Excavation” task has a “Finish No Later Than” constraint of September 15th because of an agreement with the contractor.
- The Change: The government office is slower than expected, and you have to move the end date of “Submit Permit Application” to September 5th.
- The System’s Response:
- Dependency Logic: The system sees the predecessor has been delayed. It tries to push the start date of “Begin Site Excavation” to September 6th to respect the dependency.
- Conflict Check: The system then checks if this change violates any other rules. It sees that the push to September 6th will likely cause the task to finish after its “Finish No Later Than” constraint of September 15th.
- Outcome: The system allows your change to the permit task. It then flags the “Begin Site Excavation” task with a conflict, and the Conflict Reason field will state that its schedule is violating the “Finish No Later Than” constraint.
You instantly see that the permit delay has pushed your contractor’s deadline at risk and more importantly, you can act before it snowballs into bigger issues. By combining WBS, Task Dependencies, and Date Constraints, the PK4 Automated Scheduling Engine gives project managers more than just a clear plan. It delivers a living, dynamic schedule that highlights priorities, flags risks early, and keeps everyone aligned on what needs to be done and when.
Co-Founder PK4 Tech
